Studying for the PMP exam is time consuming and demanding. The following are some suggestions on how to make the test preparation process easier and more enjoyable.
| Description | Formula | Comments |
| NPV | Present value of benefit - present value of cost |
Method for financial evaluation for long term projects. |
| # of channel of communication | N(N-1)/2 | where N is the number of project members |
| PERT | (Program Evaluation & Review Technique) | |
| EAD (Expected Activity Duration) | [P + O + 4M]/6 | O= Optimistic, M = Most Likely, P = Pessimistic You use the PERT calculation (P + 4M + O)/6 to compute a weighted average of the totals. This number represents the mean (or 50 percent point) |
| SD (Activity Standard Deviation) | [P-O]/6 | |
| Activity Variance | [(P-O)/6]2 | Standard Deviation Squared |
| Standard Deviation Squared | EAD +/- SD | Start of Range = EAD - SD, End of Range = EAD + SD |
| Range for an overall project | Project EAD +/- Project SD | Project EAD = Sum of all individual activity EAD on critical path Project SD = √Sum of all individual activity variances (√=Square root) |
| Float Activity on critical path has 0 or no float |

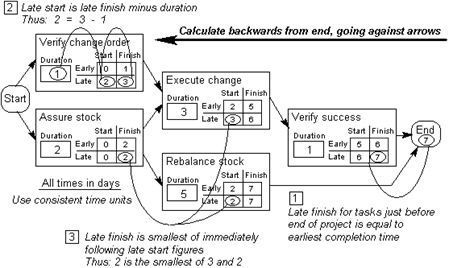

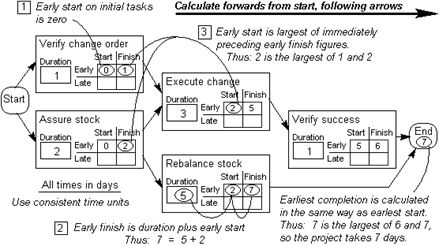

Late Start - Early Start Late Finish - Early Finish |
Both formula returns the same result If network diagram has only two paths then the difference between the two paths is the float |
| EV (Earned Value) | Estimated value of work actually accomplished | Cost to date as per the original baseline (if there are variance don't include those). EV is the cost incurred to date if we would have worked as per baseline. |
| CV (Cost Variance) | EV - AC | -ve = Above Budget = Bad, +ve = Under Budget = Good |
| SV (Schedule Variance) | EV - PV | -ve = Behind Schedule = Bad, +ve = Ahead Schedule = Good |
| CPI (Cost Performance Index) | EV/ AC | = 1 = Good = On Target, > 1 = Good , <1 = Bad |
| SPI (Schedule Perf Index) | EV/PV | = 1 = Good = On Target, > 1 = Ahead Schedule , <1 = Behind Schedule If project is close & SPI is <1 means the project got terminated |
| EAC (estimate at completion) | 1) AC + ETC 2) BAC/CPI 3) AC + (BAC-EV) |
There are many ways to calculate EAC 1) Actual + new estimate for remaining work. This is used when the original estimate is fundamentally flawed. 2) This formula is used if no variances from the BAC have occurred or you continue with the same rate of spending. 3) Actual to date + remaining budget. |
| TCPI (To Complete Performance Index) | (BAC-EV) / (BAC - AC) | Work remaining to do divided by the money remaining to do. Values for the TCPI index of less than 1.0 is good because it indicates the efficiency to complete is less than planned. How efficient must the project team be to complete the remaining work with the remaining money? It answers the question "In order to remain within the budget what rate must be met for the remaining work?" |
| ETC (Estimate to Complete) | (EAC-AC) | How much more does the project cost? Re-Estimate is the estimate from bottoms up |
| VAC (Variance at Completion) | BAC - EAC | How much under or over budget will be at the end of the project |
| Median | The middle value that separates the higher half from the lower half of data. Exam: 4 is the median in 2,4,6 (middle value) 5 is the median in 2,4,6,8 ([4+6] /2) | |
| Mode | The most frequent value in a given data set. Exam: 2 is the mode of 1,2,2,3 | |
| EMV (Expected Monetary Value) | P(Probability) * I (Impact) | P = Probability , I =Impact |
| PTA (Point of Total Assumptions) - Procurement | PTA= ([Ceiling Price - Target Price] / Buyers Share Ratio) + Target Cost |
Refers to the amount above which the seller bears all the loss of a cost overrun |
| Est. To Complete (Percentage) | EV/ BAC | |
| Present Value PV | FV / (1 + r)^n | |
| Internal Rate of Return | Bigger is better (IRR) | |
| Benefit Cost Ratio |
Bigger is better ((BCR or Benefit / Cost) revenue or payback VS. cost) Or PV or Revenue / PV of Cost | |
| Payback Period | Net Investment / Avg. Annual cash flow. | Less is better |
| Sigma σ |
|
|
| Return on Sales ( ROS ) |
Net Income Before Taxes (NEBT) / Total Sales OR | |
| Return on Assets( ROA ) |
NEBT / Total Assets OR |
|
| Return on Investment ( ROI ) | NEBT / Total Investment OR NEAT / Total Investment |
|
| Working Capital | Current Assets - Current Liabilities | |
| Discounted Cash Flow | Cash Flow X Discount Factor | |
| Contract related formulas | Savings = Target Cost - Actual Cost Bonus = Savings x Percentage Contract Cost = Bonus + Fees Total Cost = Actual Cost + Contract Cost |
- Project Plan Execution Tool:
- Work Authorization System
- It is the most important tool for the project plan execution process. It is a formal system for getting the work done at the right time and the right order. Most important pages of PMBoK are Page numbers 47, 55, 60 and 70
- Work Authorization System
- Be aware of tools and techniques used in Time, Cost, Quality, and Risk Response Planning.
- There are certain questions that contain extra information. This information is irrelevant and it does not relate to the correct answer. Beware of such questions and remember it isn't necessary to use all the information provided to answer the question.
- Each question has only one correct answer. You need to select the most correct or the one which is close to a given situation. Beware of choices that represent true statements but are not relevant. Be sure to read all the options before you select any one.
- While answering the question remember that the first priority should be given to the option which is proactive and in favor of the project. The second priority should be given to the project stakeholders.
- Avoid the answers which are in favor of the seller's organization which could not be favorable to the project.
- Any conflict should be resolved in favor of the project and/or project stakeholders.
- Beware of the following words in questions: at least, at the most, not true, not false, except.
- Look for the words, "detail", "high-Level" etc. before choosing the right answer.
- You need to answer the questions from a PMI perspective—not from your own perspective, which you acquired through experience. Remember that PMI is trying to present an ideal environment for Project Managers that might be different from your own experience.
- Beware of answer choices that represent generalizations, which may be characterized by words such as always , never, must or completely; these are often the incorrect choices.
- Look out for choices that represent special cases. These choices tend to be correct and are characterized by words such as often, sometimes, may, generally, and perhaps.
- Beware of answer choices containing words like primary and overall responsibility.
- Remember the option choice "Discuss with Senior Management" will be incorrect in most of the cases. Once the project charter is issued by senior management, the Project Manager is responsible for all the decisions.
- The correct questions may not be grammatically correct.
- Please note that there are hardly any straightforward questions appearing in the exam, like asking for a definition or asking the Input/Output for a particular process. Instead, these questions will be in a form of a scenario/story in which these processes will be integrated. You need to study the scenario and concentrate on the PMI KEY WORDS appearing in it. And figure out what exactly is the question and its correct answer.
- The Project Manager takes an active approach to the job by not waiting until a risk materializes and becomes a problem. This is an extremely important concept that might affect many questions on an exam. The Project Manager does not escalate problems to upper management or to the customer before fully analyzing them and identifying options. When answering a question related to what the Project Manager should do in a specific situation, you should rephrase the question to: What is the first thing the Project Manager will do, given such a situation and given his or her proactive nature?
- Assume that lessons learned and historical databases are available.
- PMI® does not approve adding extra functionality without benefits or gold plating.
- Project Managers have all kinds of soft and hard skills.
- The Work Breakdown Structures (WBSs) are wonderful tools.
- Roles and responsibilities need to be properly defined.
- Practice eliminating the completely implausible options first.
- There will always be those situations where you have no idea what the question is asking. Use educated guesses to select the most appropriate option. Remember, you have only 80 seconds for each question. If you do not know the answer to a question, mark it and move on and revisit it later if you have time.
- Answer the questions based on the PMBOK® concepts first, and then consider your experience. If they are in conflict, the PMBOK® wins.
- Remember your rough work should be fare particularly for Numericals. There could be multiple questions on the same numerical for CPM & EVM
- Do not mark the answers for review selected purely by educated guess. Generally the first instinct is right.
- The exam typically does not identify the form of organization you're in. When it does not specify a form, assume you're in a matrix form.
- If the question doesn't state what it is comparing to, it is comparing to a functional organization.
- The project coordinator reports to a higher-level manager and has authority to make some decisions. The project expediter has no authority to make decisions.
- Manufacturing is generally considered as a process, not a project as it is not temporary. Project charter is not appropriate in processes.
- Program is a group of related projects. If you see 'unrelated' projects it cannot be a program.
- Answers with words such as "always", "never", "must", "completely" are often the incorrect answers
- A change request is the most effective way of handling the disconnect between what users actually want and what management thinks they want.
- Differences in objectives are resolved in favor of the customer.
- The stakeholders determine the project requirements and decide whether the project was a success.
- Verify scope is closely related to perform quality control. Perform Quality Control checks for correctness, Verify Scope checks for acceptance. Verify Scope does not deal with time, but rather acceptance.
- The heuristic (rule of thumb) we use in project decomposition is 80 hours. It doesn't matter how experienced the team members are. You need this level of reporting to manage the project effectively.
- You have a responsibility to refrain from accepting inappropriate forms of compensation for personal gain.
- Administrative closure activities should be carried out at the completion of each phase of a project. This is particularly important and has a significant role in assessing whether the project can be continued into its next phase.
- One has no conflict of interest as long as he is not speaking for a specific supplier. Honorariums and expenses are a common incentive for speakers. Accepting an honorarium and expenses is neither illegal nor unethical.
- Break-even capacity is reached when the total profits equals total expenses.
- Per the PMBOK guide, the project charter should be published under the name of a manager external to the project. The charter is NOT published under the Project Manager's name. According to the PMBOK the sponsor is considered to be external to the project, and thus is usually the name in which the charter is published.
- During the initiation of a project - Staff Levels are low and the costs are low but stakeholder influence is high and the risks are high so the chances of success are lower.
- The Project Manager is responsible for predicting materials, equipment, and work required for a project but not predicting project performance; it should be a pre-defined requirement determined by the stakeholders and should fall within a specific set of parameters.
- Standards are optional and may sometimes be called guidelines. Regulations are not optional and are typically enforced by laws.
- Lessons learned are best completed by the stakeholders, as their input is critical for collecting all the lessons learned on each project. The term "stakeholders" includes all the other groups.
- A project is complete when all work, including all project management work, is complete and the product of the project, not just deliverables, accepted. The lessons learned are project management deliverables. So even if the client accepts deliverables the project is not complete unless lessons learned are also completed.
- Triple Constraint: Triple Constraint being quality (scope), cost (resources) and schedule (time). These three elements of a project are known to work in tandem with one another. Where one of these elements is restricted or extended, the other two elements will then also need to be either extended/increased in some way or restricted/reduced in some way.
- Administrative closure — generating, gathering, and disseminating information to formalize phase or project completion.
- The project life cycle differs from the product life cycle in that the project life cycle is different for each industry.
- One way the Close Project/Phase process differs from Close Procurement is - Procurement closure means verifying that the project is complete or terminated; Close Project or Phase is the process of tying up all of the activities for every management process group
- A stakeholder is anyone who is affected by the cost, time, or scope of your project. And that includes unions - if you have team members who are in a union, then you always need to consider that union as a stakeholder and make sure their needs are met. However, you don't need to consider the needs of your company's competitors and or Media professionals.
- The most effective type of power for a Project Manager is Expert power. That's when your team respects you because they know that you know what you are talking about.
- An important part of identifying stakeholders is reviewing lessons learned from prior projects (because they may help you identify stakeholder issues early), perform stakeholder analysis (which often involves a power/interest grid), and review procurement documents (because a contract often brings extra stakeholders with it). However, you don't create the change control system in the Initiating phase - that's something that you do as part of your project planning activities.
- Obtaining formal acceptance of all deliverables from all stakeholders is NOT part of the Close Project or Phase process as by the time the Close Project or Phase process happens, you should have already gotten formal written acceptance for the deliverables. That's what the Verify Scope process is for
- What are the 5 kinds of power? - Legitimate, expert, reward, referent, and punishment
- When is the BEST time to have project kickoff meetings? - At the start of each phase. If your project is broken up into phases, you should have a Kickoff meeting at the start of each phase.
- Customers can be satisfied even when a project is not profitable - customer satisfaction isn't always about money. Rather, customer satisfaction is about making sure that the people who are paying for the end product are happy with what they get.
- When someone is given the job of Project Manager they will have formal, reward, and penalty power. But just having the position does not make the Project Manager either a technical or project management expert.
- From the seller's perspective if the project team has finished all the work as per procurement SOW and the final deliverable has been sent to the customer (waiting signoff) then the project is considered to be in the closing process group and not yet completed.
- Changes are not listed in the scope management plan.
- Stakeholder's expectations are unspoken requirements and are often more critical to a project's stakeholders than the stated ones. Unless these expectations are identified and recorded, there is likely to be a high level of dissatisfaction with the project. We know personality conflicts are the least frequent sources of conflict so this choice cannot be the best.
- Matrix Organization is best for managing complex projects involving "Cross Disciplinary Efforts".
- Project Selection Methods.
Benefit Measurement Methods
- Murder Board
- Peer Review
- Scoring Models
- Economic Model
- Present Value
- Net Present Value (If NPV is positive the investment is good choice. Project with highest NPV is selected.)
- Internal Rate of Return (IRR)
- Payback Period (Time period to recover the investment)
- Benefit Cost Ratio (BCR > 1 means revenue is more than cost, <1 means cost is more than revenue, =1 means revenue and cost are equal).
When you're asked to use benefit-to-cost ratios (BCR) to select a project, always choose the project with the highest BCR because that's the project that gives you the most benefit for the least cost. An easy way to do it is to divide, as in: Project A has a BCR of 5:2, and 5 / 2 is 2.5. Do that with all four projects, and you find that project C has the highest BCR.
- Constrained Optimization Methods
- Linear Programming
- Integer Programming
- Dynamic Programming
- Multi-Objective Programming
- Economic Value Added (EVA) - Amount of added value the project produces above the cost.
- Opportunity Cost - Opportunity given up by selecting one project over another (this does not require calculation, the left project value is the opportunity cost and not the difference)
- Sunk Cost - The money is already spent. Sunk cost should not be considered when deciding whether to continue with the project or not.
- Law of Diminishing Returns - After a certain point, adding more input (eg. Programmers) will not produce proportional increase in productivity. (e.g. modules per hour)
- Working Capital = Current Assets - Current Liabilities.
- Depreciation - Large Asset purchased losing value over time:
- Straight Line Depreciation - Same amount of depreciation taken each year
- Accelerated Depreciation - Accelerated depreciation depreciates faster than straight line.
- Performance Measurement Baseline (Together Scope, Schedule and Cost baselines are called Performance Measurement Baseline).
- Monitoring and controlling means measuring against the project management plan.
- If the exam asks about monitoring and controlling work, it may NOT be talking about the entire monitoring and controlling process group, just the integration process.
- If the exam asks what should you do if a work activity on the project takes longer than estimated, the answer is to take corrective action to make up for the delay to keep the project on or close to schedule.
- For the exam, assume that all the projects have change control boards.
- The tip to answer questions that asks about the process for making changes is to know that the Project Manager should follow these steps:
- Evaluate the impact
- Create options
- Get change request approved internally
- Get customer buy-in (if required)
Does the change fall within the project charter or is the change beneficial to project or really needed? If the answer is no for both questions then it should not be a change to your project and rather should be a new project. Project Manager can reject such changes.
- One of the ways to check if a change should be approved is to determine whether the work falls within the project charter. If not, it should be rejected, assigned to a more appropriate project, or addressed as a project of its own.
- If a change does not affect the project management plan, baselines, company policies, procedures, the charter the contract, the scope, then the company change management policies may allow Project Manager to approve the change otherwise this often goes to a change control board.
- Changes are always evaluated first.
- Scope management involves both Product Scope and Project Scope. Be careful here to notice which word is used on the exam as the answer to either will be different.
- Requirements collection techniques (inputs):
- Interviewing
- Focus Groups
- Facilitated Workshops - (various stakeholders with different ideas come to a consensus)
- Brainstorming
- Nominal Group Technique
- Delphi Technique - Experts participate anonymously. The rules of the Delphi technique are: keep the expert's identities anonymous, do not bring the experts together in the same room, and build consensus.
- Mind Maps
- Affinity Diagrams - various ideas sorted into groups by similarities
- Questionnaires and Surveys
- Observation - Job Shadowing
- Prototype
- Group Decision Making:
- Dictatorship - single person make decision for entire group
- Plurality - Majority Approach
- Consensus Technique
- Resolving Competing Requirements - The Project Manager should facilitate the resolution of competing requirements by accepting those that comply with the following:
- The business case stating the project was initiated (market demand, legal requirement etc.)
- The project charter
- The scope statement
- The project constraint
- Verify Scope process is done during the Monitoring and Controlling process group, not the closing process group.
- In define activity process, the WBS is decomposed into activities (schedule activities) and not work package. WBS is used for estimating activities, costs, and resources.
- A WBS does not show dates or responsibility assignments. It can be used communicating with customer.
- WBS can be used (but does not need to be used) as a communications tool for all stakeholders to "see" what is included in the project.
- What are the valid ways to breakdown the work in a WBS; by project phase or project deliverable.
- Project Manager role during execution: During project execution, the Project Manager should be focused on integrating the work of others into a cohesive whole.
- Only a work authorization system helps with integrating work packages into a whole. A work authorization system helps ensure that work is done at the right time and in the right sequence.
- The work authorization system is a part of your company's Enterprise Environmental Factors, and it's generally part of any change control system. It defines how work is assigned to people. If work needs to be approved by specific managers, the work authorization system will make sure that the right people are notified when a staff member's work assignments change.
- Rules for when a change should formally be made are discussed or set up during project planning and must follow any company policies. These plans would be included or referenced in the project's change control system.
- A project is considered closed when the archives are completed.
- Whenever a large number of changes occur on a project, it is wise to confirm that the business case, as stated in the project charter, is still valid.
- Project Integration is a key responsibility of the Project Manager, not the team.
- The sponsor issues the project charter and so he or she should help the Project Manager control changes to the charter. The primary responsibility lies with the sponsor.
- Who does each activity is managed with the schedule and responsibility assignment matrices.
- When each activity is done is managed with the project schedule.
- A work authorization system is used to coordinate when and in what order the work is performed so that work and people may properly interface with other work and other people.
- Delphi technique leads to consensus of expert opinion and is therefore the best technique to determine project objectives.
- Did you know that adding milestones is a control feature? If a milestone is completed on time and on budget, the Project Manager has some measure of the status of the project.
- The project scope statement defines the total scope of the project (what is in scope and what is out of scope). According to the PMBOK® Guide, it is used as a baseline for evaluating change requests and for guiding the project team's work through the executing processes.
Time Estimation Techniques
| Time Estimation Techniques | |
| One Point Estimation | |
| Analogous or Top Down Estimation | Uses Expert Judgment and Historical Information to predict future Analogous estimating uses a similar past project to estimate the duration or cost of your current project, thus the root of the word: analogy. Used when there is limited information regarding your current project, an analogous estimate is considered "top-down" and is generally not as accurate as other estimating techniques. |
| Parametric Estimation Regression Analysis or Scatter Diagram Learning Curve |
A more accurate technique for estimating cost and duration, uses the relationship between variables to calculate the cost or duration. Essentially, a parametric estimate is determined by identifying the unit cost or duration and the number of units required for the project or activity. |
| Heuristics | Means a rule of thumb. 80/20 rule is an example |
| Three point Estimation or PERT (Program Evaluation & Review Technique) | With the three point technique estimator give an Optimistic (O), pessimistic (P) and most likely (M) or Realistic (R) estimate for each activity. (Most Likely or Realistic are the same) |
| Reserve Analysis | |
| Schedule Network Analysis | |
| Critical path method | The longest duration path through the network diagram and determine the shortest time to complete the project. Identify all the paths through the network diagram and add the activity duration along each path. The path with the longest duration is the critical path. |
| Near Critical Path | Path which is closest in duration with critical path. Something could happen that shortens the critical path or lengthens the near critical path to the point where near critical path becomes the critical path. The closer in length the near critical path and critical paths are, the more risk the project has. |
| Schedule compression | |
| What -if scenario analysis | Monte Carlo Analysis |
| Resource Leveling | Produce resource constraint schedule, let the schedule slip and increase cost |
| Critical Chain Method | Adds buffer to the schedule |
| Float or Slack | -ve float = you're behind, schedule compression required to get back on track Total float - Amount of time activity can be delayed without impacting project/milestone end date Free float - Amount of time activity can be delayed without delaying the early start of successor activity Project Float - Time the project can be delayed without delaying the externally imposed project end date. |
|
Path Convergence
|
Path convergence is characterized by an activity with more than one predecessor activity. The merging or joining of parallel schedule network paths into the same node in a project schedule network diagram. |
| Milestone chart | Tool to report to management and customer |
| Bar chart | Tool for progress reporting and control. To report to team |
| Network diagram | Tool to show dependencies |
- In sequence activity process activities are sequenced into network diagrams.
- Scope baseline involves = Scope statement, WBS, WBS Dictionary.
- The scope baseline is not a particularly useful thing once a project's done. A baseline is what you use to measure any changes to the project - whenever there's a change, you always want to compare it against the baseline. But once the project is done, the baseline isn't necessary any more.
- The WBS dictionary should be documented with the code of account identifier, a statement of work, the responsible organization, and a milestone schedule for the WBS components.
- Methods to draw a network diagram:
- Precedence Diagramming Method (PDM) or Arrow On Node (AON)
- Arrow Diagramming Method (ADM)
- GERT - A modification to network diagram drawing method allows loops between activities
- Dependencies - The sequence of activities are determined based on the following dependencies:
- Mandatory Dependencies (Hard Logic)-
- Discretionary Dependencies (also known as Preferred, Preferential and Soft Logic); this is determined by the project team and can be changed if required. These dependencies are important to determine the fast track for projects.
- The team must approve the final schedule.
- Logical relationship between activities:
- Finish to Start (FS), Start to Finish (SF), Start to Start (SS), Finish to Finish (FF)
- Finish to Start (FS), Start to Finish (SF), Start to Start (SS), Finish to Finish (FF)
- Lead - Added to start an activity before the predecessor activity is completed.
- Lag - Inserted waiting time between activities.
- Adjusting Leads or Lags does not alter the relationship (start to finish etc) of the activities, but applies a delay or head start to activities.
- Estimation has two parts:
- Estimate Activity Resources
- Estimate Activity Durations
- Crashing: employ more resources to meet the deadline, often results in increased cost.
- Fast tracking: doing tasks in parallel, often results in reworks and usually increases risk. You would want to fast track activities on the critical path in order to save time. Fast tracking the project adds risk since more activities are done in parallel.
- Contract closeout happens before administrative closure.
- More interdependencies on a project increase the need for communication.
- You do not necessarily need to change the schedule; unless, of course, the delay is more than the activity's float.
- The critical path does not change if the scope is the same.
- Since the resource is 50 percent as productive, he will take twice as long to do the same work. This makes the duration of activity G 16 instead of 8 and increases the critical path by 8 to a total of 52
Cost Estimation
| Cost Estimation | |
| Life Cycle Costing | Concept of looking at the cost of the entire life cycle of product, not just the cost of project |
| Value Analysis or Value Engineering | Finding a less costly way to do the same work. If a team is looking at decreasing project cost maintaining same scope they perform value analysis |
| Rough Order of Magnitude | +/- 50% of accuracy. Happens in initiation phase |
| Budget Estimate | Made during planning phase and in range of -10 to +25 % from actual |
| Definitive Estimate | Made during project. Range of +/- 10% or -5 to +10% from actual |
| Progress Reporting | 50/50 Rule - 50% credit when work begin and remaining 50% on completion 20/80 Rule - 20% credit when work begin and remaining 80% on completion 0/100 Rule - no credit when work begin and until completion |
| PV (Planned Value) | Original cost baseline |
| EV (Earned Value) | Estimated cost of work completed to date per baseline (without considering any deviation). Earned value measurement is a great reporting tool. With it, you can show where you stand on budget and schedule, as well as provide forecasts for the rest of the project. |
| AC (Actual Cost) | Actual cost incurred for work completed to date |
| Actual cost incurred for work completed to date | Total Budget |
| EAC (Estimate At Completion) | Current forecast; an estimate at completion is an output of the Control Costs process |
| ETC (Estimated To Complete) | Remaining work |
| VAC (Variance Actual Cost) | Variance (over or under budget) from today until end of project |
|
There are five types of costs in a typical project: |
Fixed - A fixed cost is a non-recurring cost that will not change as the project progresses. For example, if you are constructing a road, the excavators and bulldozers are fixed costs. For software development projects, the physical development space and development computers are fixed costs to the project. Variable - Variable costs are costs that change during the project lifecycle. Construction projects usually have a long duration and can easily span several years. e.g During the construction of this project there were several variable costs, such as fuel costs and labor rates, number of resources etc Direct - Direct costs are expenses that come out of the project budget directly. For example, if you have outsourced some of your development work, the developers are expected to put in a specific amount of time, which is then billed for. The developer salaries are direct costs. Indirect - Indirect costs are those that are shared across multiple projects. Indirect costs are sometimes also referred to as Oversight costs. |
| Indirect Cost | Indirect costs are costs that are not directly related to the project or project deliverables, but can provide tangible benefits to the project. |
| -Indirect costs are used in the make or buy calculations - e.g Sarah feels that buying lunch for her team every week is a great way to keep them motivated. - Fringe benefits are included in overhead and are part of indirect costs. - Indirect costs are usually computed as a percentage of direct costs. |






Mahesh ChandPosted Jun 16, 2012, 10:03 AM
I agree with Sam. I worked at PMI (Project Management Institute). Actually, the company is like 15 minutes from where I live. I worked on their website that will let Project Managers to take test online.
Lajapathy ArunPosted Jun 16, 2012, 9:12 AM
Thanks for sharing.
Dinesh BeniwalPosted Jun 16, 2012, 8:02 AM
Good work.
Sam HobbsPosted Jun 16, 2012, 3:11 AM
That is a huge article! Thank you. It is obviously the result of extensive experience. I hope it helps many project managers. I do not have any experience as a project manager but on the subject of conflicts, I would expect that the cause of many conflicts would be miscommunication.
